Sample report page 1Sample report page 2Sample report page 3Sample report page 4Sample report page 5Sample report page 6Sample report page 7Sample report page 8Sample report page 9Sample report page 10Sample report page 11Sample report page 12Sample report page 13Sample report page 14Sample report page 15Sample report page 16Sample report page 17Sample report page 18Sample report page 19Sample report page 20Sample report page 21Sample report page 22

Sample closing timeline add-on ($79)

Written for each deal from its screen and the buyer's financing plan. Fictional business, for illustration only.

Closing timeline — Sample HVAC services

Expected length: 12-16 weeks

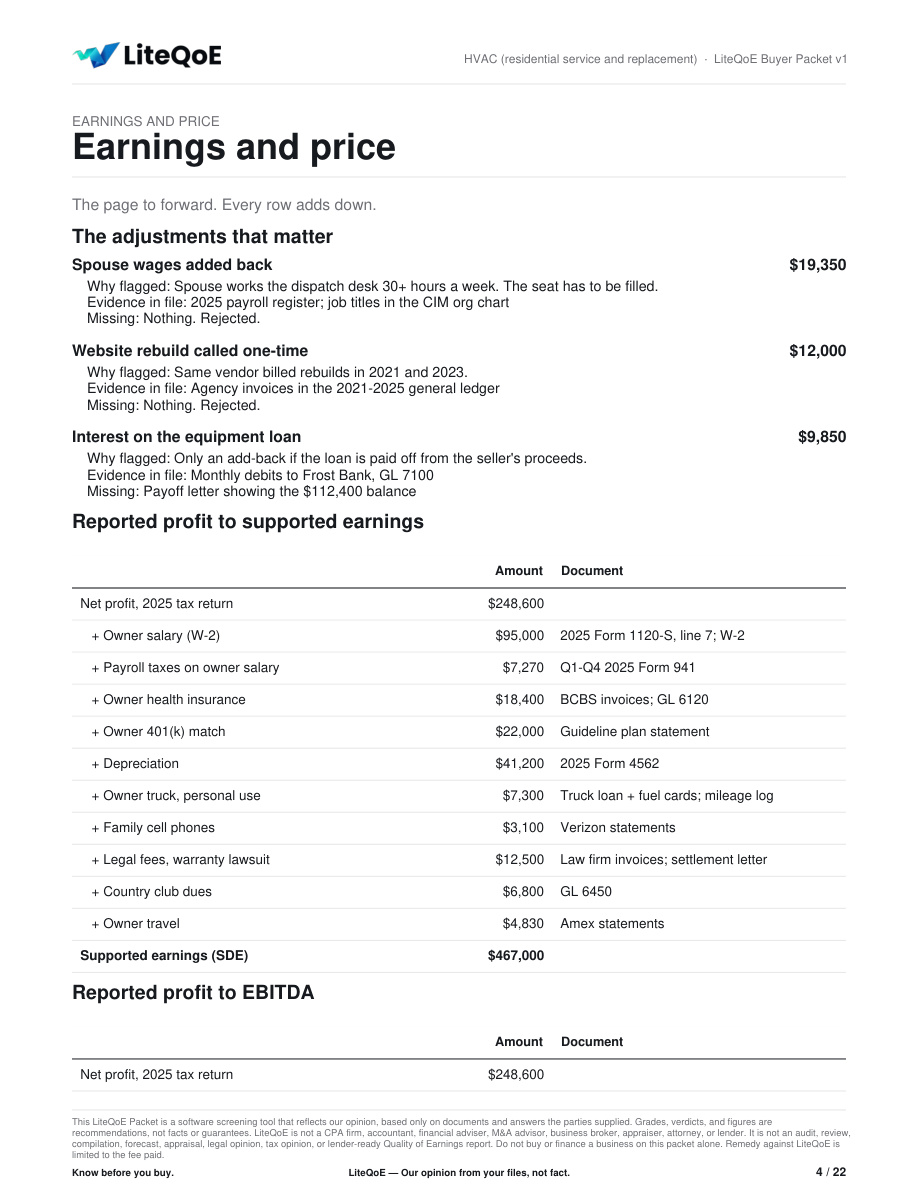

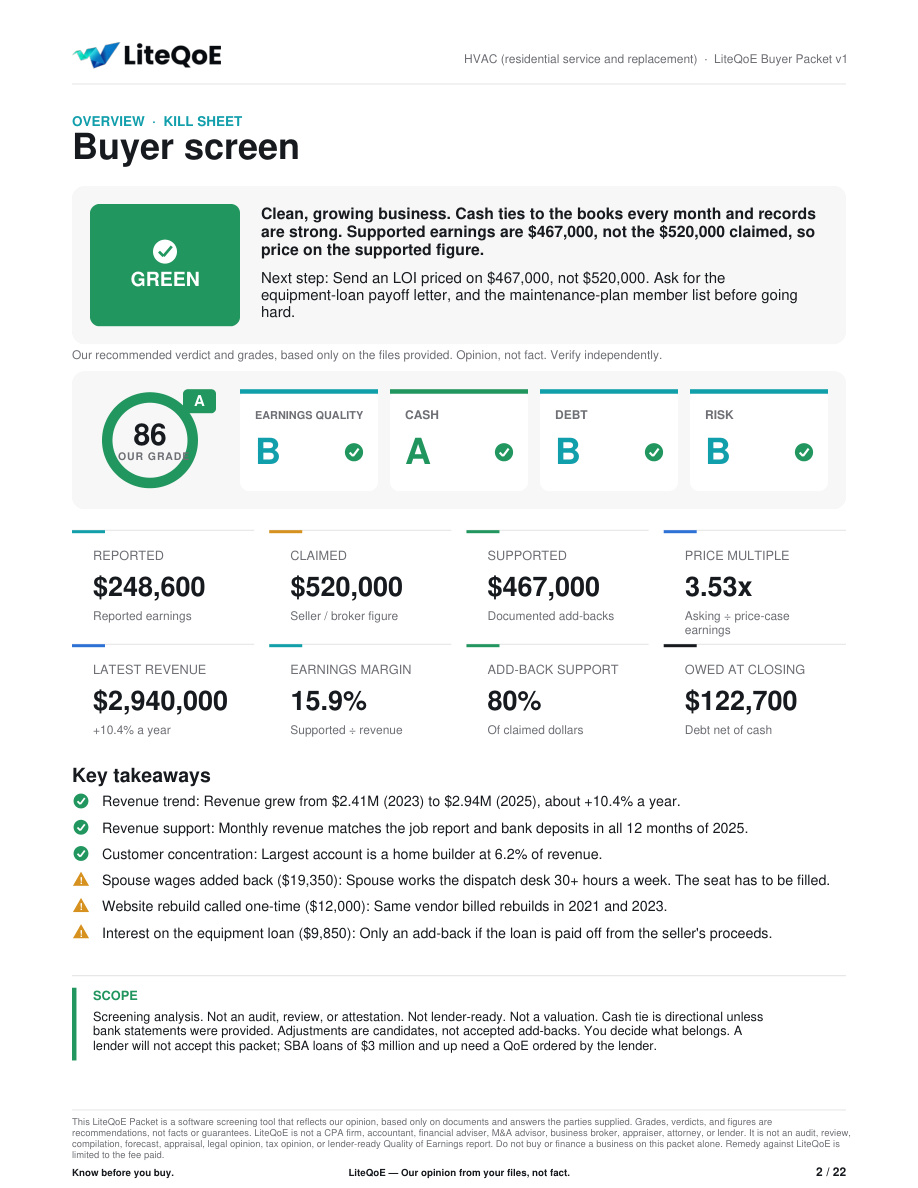

An SBA loan with a seller note sets the pace here: the lender's QoE, valuation, and credit approval usually take 6-8 weeks. Two open items from the screen, the unsupported $38,000 add-back and the equipment loan, should be settled before the purchase agreement is final.

  1. LOI signed and kickoff

    Week 1
    • Sign the LOI and confirm the exclusivity end dateBuyer, seller

      Your 60-day window is the clock for everything below.

      Done when: Signed LOI saved and dates on your calendar

    • Send the diligence request list to the brokerBuyer

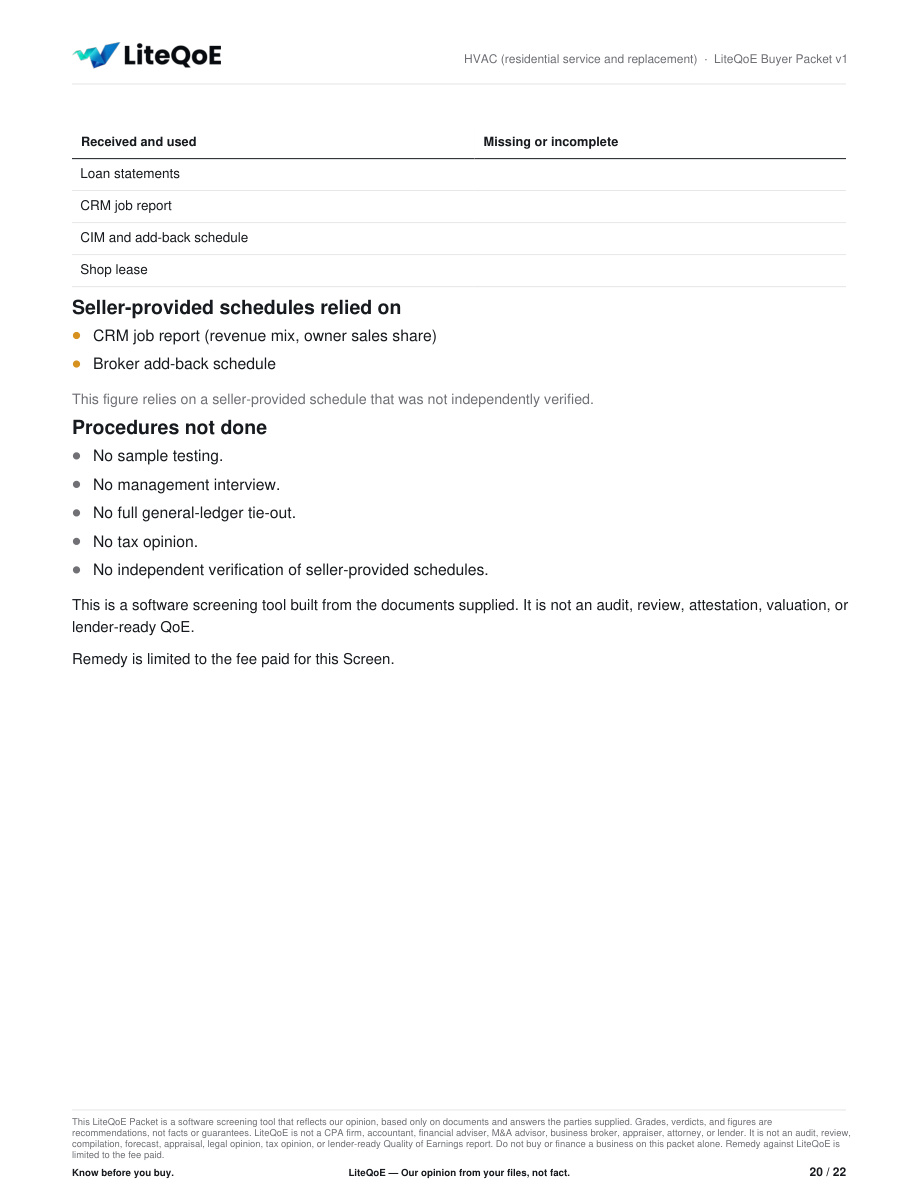

      The screen flagged missing 2025 monthly bank statements and AR aging.

      Done when: Broker confirms a delivery date

    • Engage a deal attorney and a CPABuyer

      Both need lead time; ask your attorney about entity setup now.

      Done when: Engagement letters signed

  2. Financial due diligence and CPA work

    Weeks 1-4

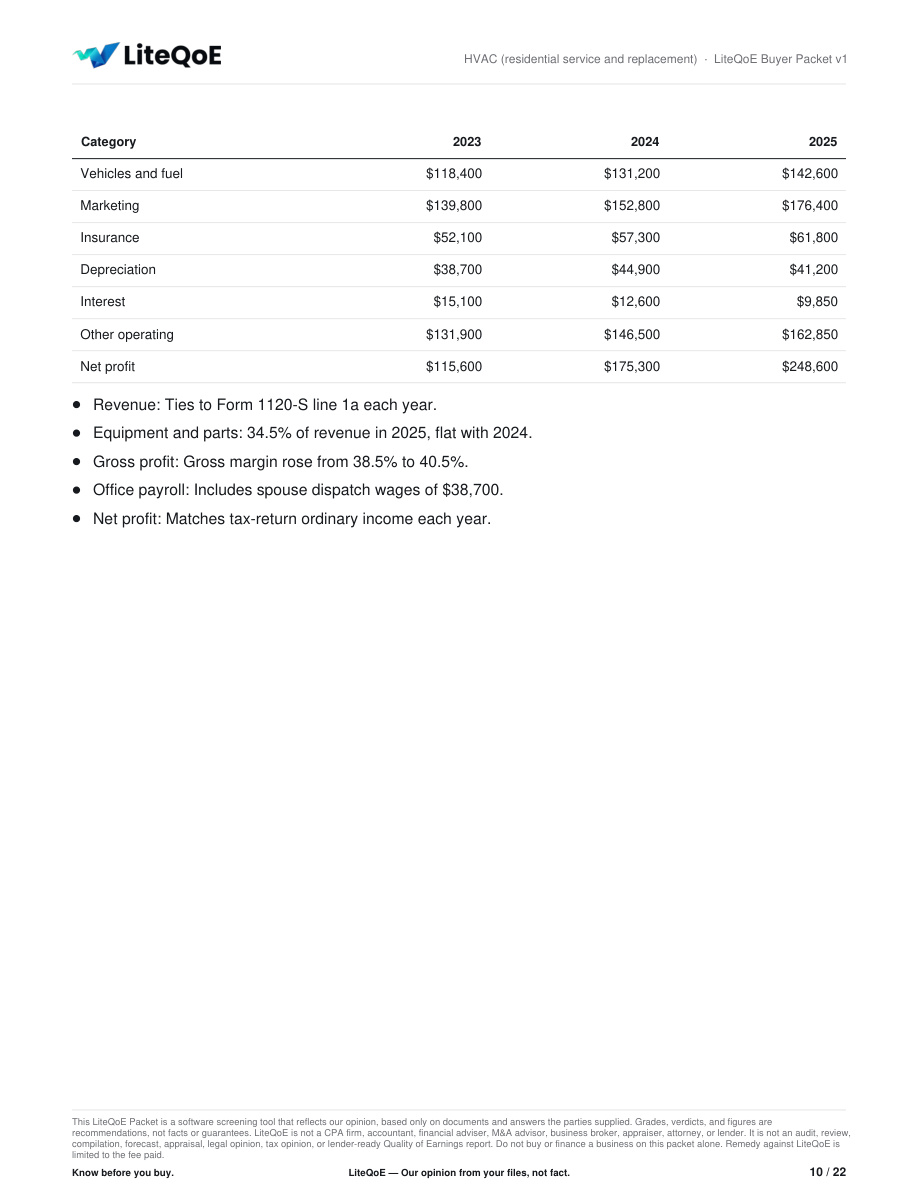

    • Tie 24 months of bank deposits to reported revenueCPA

      The screen read only 10 months of statements, so cash is not confirmed.

      Done when: Variance under 3% or explained

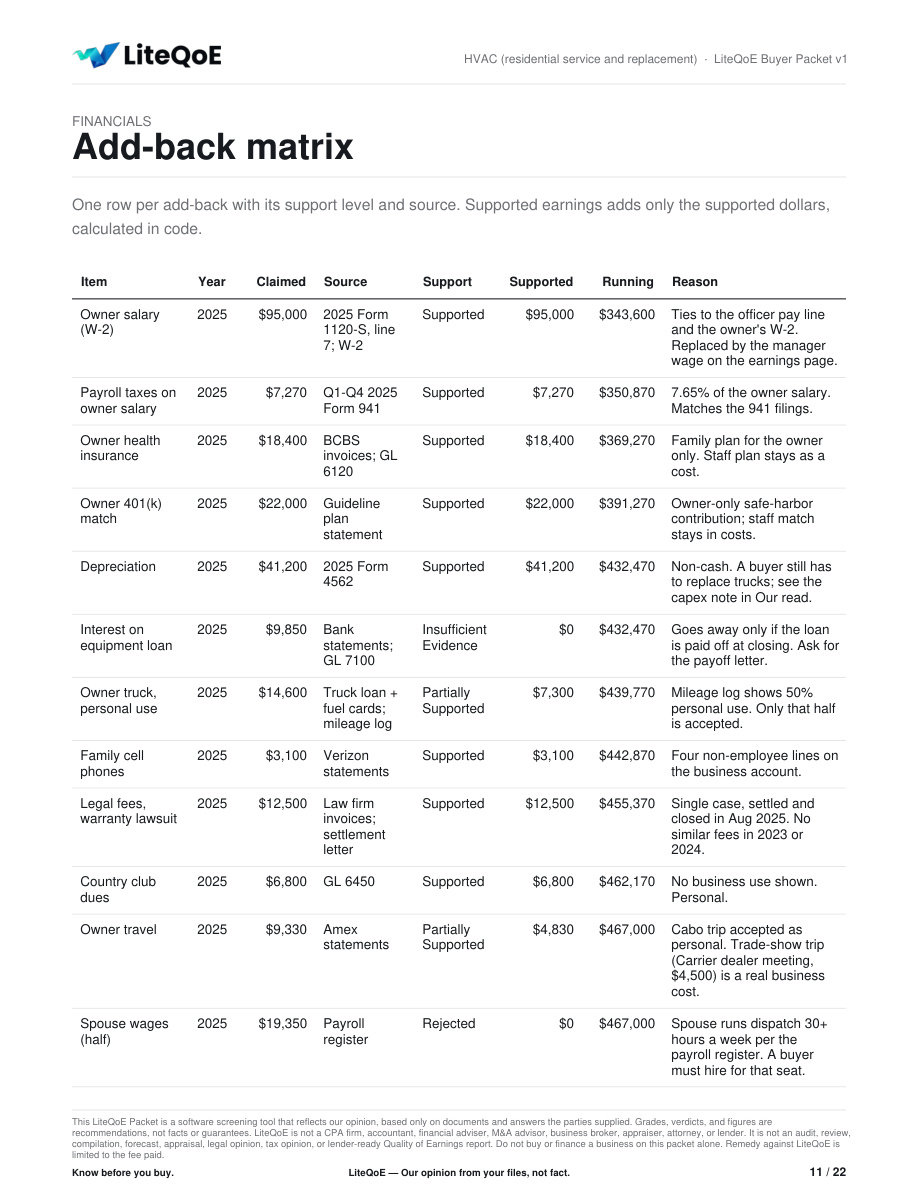

    • Get proof for the $38,000 owner vehicle add-backSeller, CPA

      Rejected on the screen for lack of support; it moves price by about $106,000 at the asking multiple.

      Done when: Titles and mileage logs received, or add-back dropped

    • Review AR aging and the top five customer contractsBuyer

      Top customer is 22% of revenue.

      Done when: Contract terms and renewal dates documented

  3. Financing application and lender QoE

    Weeks 2-8
    • Submit the SBA 7(a) application packageBuyer, lender

      You chose SBA plus a seller note.

      Done when: Lender confirms the file is complete

    • Prove your equity injectionBuyer

      SBA lenders often ask for 10% down, sourced and seasoned.

      Done when: Bank statements accepted by the lender

    • Support the lender-ordered QoE and business valuationQoE firm, seller

      This screen is not lender-ready; the lender orders its own.

      Done when: QoE and valuation reports delivered

    • Agree seller note terms and any standby periodBuyer, seller, lender

      SBA rules often put the seller note on standby.

      Done when: Note terms in the term sheet

  4. Operations, people, and lease

    Weeks 3-8
    • Ask the landlord for a lease assignment or new leaseSeller, landlord

      The lender usually needs lease term to cover the loan.

      Done when: Signed assignment or letter of intent from landlord

    • Confirm technician licenses transfer or stayBuyer

      The owner holds the state contractor license.

      Done when: Licensing path agreed in writing

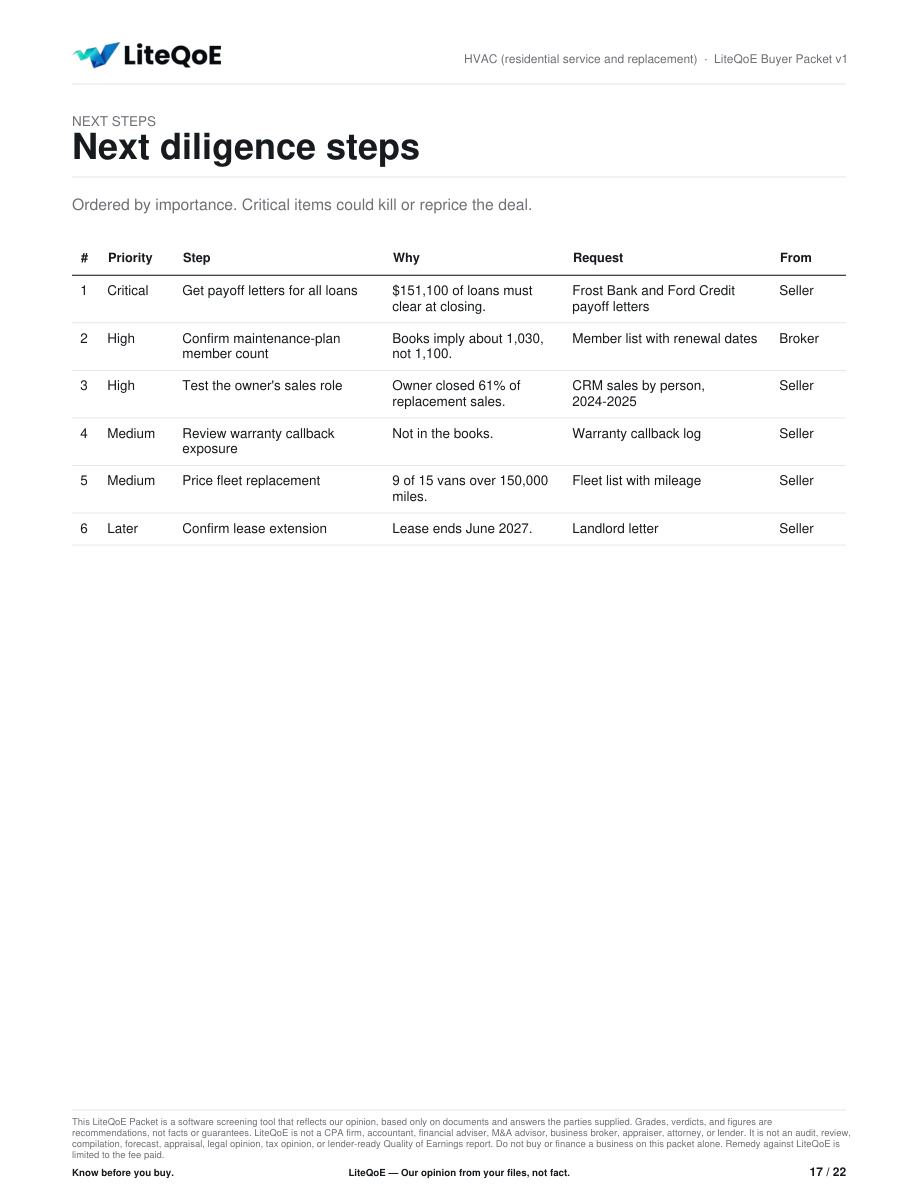

    • Get payoff letter for the equipment loanSeller

      Listed as a $64,000 debt-like item on the screen.

      Done when: Payoff letter in hand

  5. Purchase agreement and redlines

    Weeks 6-11
    • Draft the asset purchase agreementAttorney

      Start once diligence findings are mostly in.

      Done when: First draft to seller's attorney

    • Redline reps, warranties, and the working capital pegAttorney, buyer

      Ask your attorney how to cover the open add-back and AR issues.

      Done when: Both sides sign off on final draft

    • Review disclosure schedules line by lineBuyer, attorney

      Schedules are where surprises hide.

      Done when: Schedules final and attached

  6. Approval and closing prep

    Weeks 10-14
    • Receive final loan approval and commitment letterLender

      Nothing closes without it.

      Done when: Commitment letter signed

    • Bind insurance and open business bank accountsBuyer, insurance agent

      Lenders require coverage at closing.

      Done when: Certificates sent to the lender

    • Plan the owner transition and employee announcementBuyer, seller

      Owner runs dispatch and key accounts today.

      Done when: Written 90-day transition plan

  7. Closing and day one

    Weeks 12-16
    • Do the final walkthrough and inventory countBuyer, seller

      Confirms assets match the agreement.

      Done when: Count signed by both sides

    • Approve the funds flow memo and sign closing documentsAttorney, lender, buyer

      Check every payoff on the memo, including the equipment loan.

      Done when: Funds wired and keys handed over

Watch closely on this deal

  • Bank statements for 2024 are still missing; lender QoE will need them.
  • Top customer at 22% of revenue — ask for a meeting before closing.
  • Owner holds the contractor license; plan the transfer early.
  • The $38,000 vehicle add-back may not survive the lender's QoE.

Planning guide built from a screening analysis. Not legal, tax, or lending advice. Not a Quality of Earnings. Real dates depend on your lender, lawyer, CPA, and the seller. Confirm every step with them.
